OutsourcingVN is operated by Netbase JSC. This is buyer guidance for work we may be asked to deliver, not legal or procurement advice and not a compliance guarantee. Use it with the guides index, qualified advisers and the people authorised to accept security and accessibility evidence.
Identify the commissioning context
- Write requirements by service type
- Make acceptance observable
- Map supplier and data responsibilities
- Keep Work evidence bounded
- Build the release pack
- Hold a sector and acceptance workshop
- Common questions
- Prepare a buyer brief
Write requirements by service type
| Topic | Public-sector buyer question | Private-sector buyer question | Evidence |
|---|---|---|---|
| Accessibility | Which published requirement and statement process apply? | Which users, commitments and standards does the organisation adopt? | Tested journeys, defects, exceptions and owner sign-off |
| Procurement | Which tender, assurance or supplier artefacts are required? | Which internal approval and contract controls apply? | Bid or approval record and named decision maker |
| Security | Which authority accepts risk and incidents? | Which authority accepts risk and incidents? | Access matrix, test record and recovery exercise |
| Content | Who approves legal or service wording? | Who approves customer wording? | Versioned content and review owner |
| Operations | What support and change record is required? | What support and change record is required? | Runbook, escalation route and handover |
The distinction is useful because the same interface may need different evidence depending on the commissioning body. Start with a small set of journeys: sign-in, application, payment if relevant, document download, error recovery and support contact. Define whether each has keyboard, screen-reader, visual, content and assisted-service considerations, based on the buyer's approved scope.

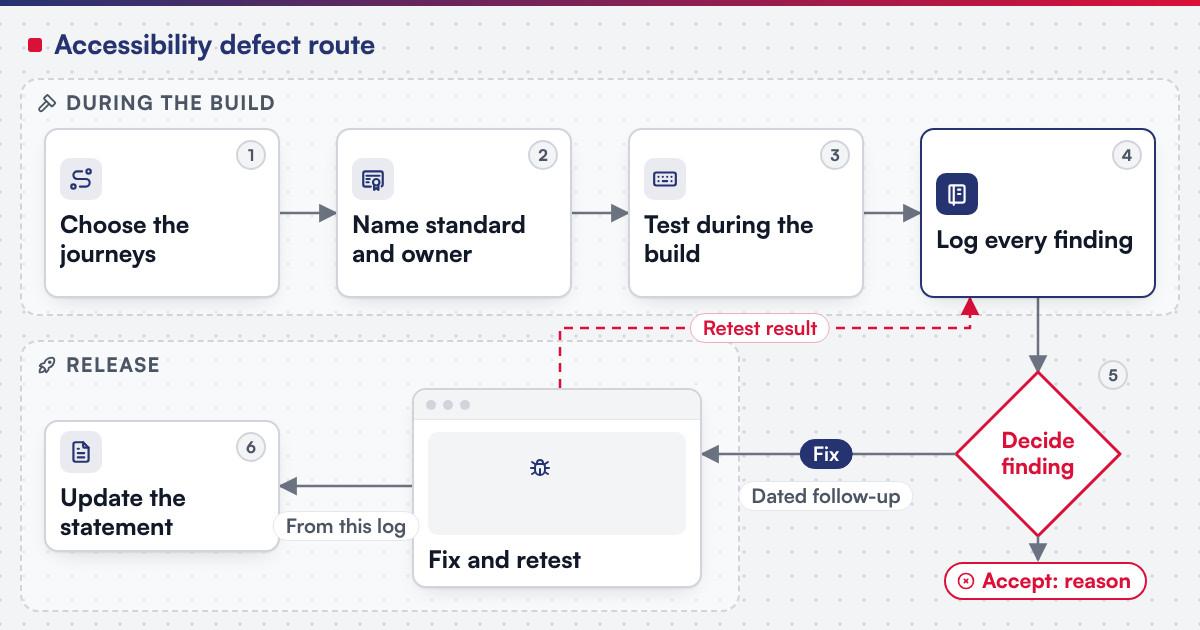

Make acceptance observable
-
Name the service and sector owner
They decide which requirements apply and what proof they will accept.
-
Turn obligations into journeys
Avoid a generic “accessible” requirement; state what users must be able to complete and under which conditions.
-
Set test roles and evidence
Name internal reviewers, independent testers where required, defect severity rules and the record that closes a finding.
-
Test security operations
Demonstrate account administration, least-privilege decisions, logging, recovery and escalation against the agreed scope.
-
Prepare the statement and handover
If the buyer requires a published statement or procurement artefact, assign its owner and source evidence before release.
Accessibility and security testing should be planned through design and build, not added after a feature demonstration. A first release can be limited to a defined service path, but its limitations must be visible to the buyer who owns the decision to launch.
Map supplier and data responsibilities
List the buyer, delivery supplier, hosting provider, identity provider, payment provider and support teams that touch the service. Ask the buyer's advisers which agreements, data roles and evidence are needed. For the technical scope, record the system boundary, credentials, data transfers, monitoring owner, incident escalation and offboarding action for each contributor.
Procurement should request the right evidence rather than a broad assurance claim. A buyer might need a description of development controls, a test approach, an accessibility defect log, a security architecture decision or a handover plan. The supplier should state what it can provide and what remains the buyer's governance responsibility. This avoids implying a certification or compliance status that the record does not support.
Use the total software delivery cost guide to include discovery, content review, testing, remediation and operational handover in the comparison. An initial build scope without those activities may describe a different risk allocation.
Keep Work evidence bounded
The 4over4 print-commerce conversion record reports a specific delivered scope and its evidence limits. It is adjacent product evidence only. It does not prove UK delivery, public-sector procurement experience, accessibility conformance, UK GDPR compliance, local capacity or a result for another buyer.
Custom Product Engineering is the service route once the buyer has defined users, systems and acceptance evidence. The global delivery page describes remote delivery and does not assert a UK office or local project team.
Plan the next step for your project
Build the release pack
The release pack should name the buyer's policy owner, procurement owner, accessibility owner, security owner, support lead and technical administrator. Include agreed test evidence, open issues, exceptions, residual-risk decisions, accessibility-content ownership and recovery contacts. Exercise the route for a defect or incident before handover. The goal is a service the organisation can govern after the delivery team leaves.
Hold a sector and acceptance workshop
Ask the commissioning owner to state the sector context, procurement to list approval artefacts, accessibility to choose representative journeys, and security to define acceptance evidence. Capture uncertainty for the buyer's qualified advisers rather than turn it into a supplier assertion.
Use scenarios for keyboard completion, content error, failed sign-in, access removal, recovery and an unresolved defect. Record observed behaviour, priority and the buyer's decision to remediate, defer or exclude. At handover, name the content-change owner, accessibility-report route, supplier-evidence reviewer and security-alert recipient.
Common questions
During acceptance, record which party supplied each procurement, accessibility and security dependency and which questions remain for the buyer's advisers. This avoids calling a controlled demonstration a complete service when a policy decision, evidence review or operating route is unfinished. A launch decision should name those gaps, their impact and the accountable owner.
Keep that record with the handover pack for later independent formal review.
Before comparing proposals, give every supplier the same service journeys, commissioning context, procurement route, acceptance owners and security boundary. Ask them to state assumptions and exclusions about testing, content, remediation and handover. This makes it possible to distinguish a defined evidence plan from a generic claim that a finished service will meet every buyer requirement.
Keep a decision log for findings discovered during delivery. For each accessibility or security issue, retain the journey, observed condition, impact as assessed by the buyer, owner, proposed response and acceptance result. The log supports transparent handover and allows a later procurement or assurance review to see what was tested. It does not replace the buyer's legal or sector-specific determination.
No. The buyer must establish applicability with qualified advisers; this guide keeps public and private questions separate.
A supplier should provide the agreed evidence. The buyer's accountable owners and advisers decide whether it meets the applicable requirement.
It includes the agreed user journeys, supporting content and the evidence the buyer has specified, rather than a blanket claim.
Prepare a buyer brief
Bring the commissioning context, service journeys, procurement route, user evidence, current systems and named acceptance owners. The Nigeria guide covers payment-provider roles, and the UAE guide covers jurisdiction, identity and Arabic acceptance; neither determines UK obligations.
Read the methodology, then submit a project with the first service path. OutsourcingVN is Netbase's own outsourcing-services platform, and a person will assess whether discovery or a bounded implementation is the honest next step.
